Mayor Danny Avula, City of Richmond Highlight One Year of Action to Strengthen Richmond’s Water System
All consent order requirements have been met, switchgear project completed
Richmond, VA - One year after a major water system failure, Mayor Danny Avula marks a year of decisive action that has strengthened the region's water system, restored compliance, and significantly improved preparedness for the future.
Over the past 12 months, the City has completed infrastructure upgrades, met all consent order requirements, and rebuilt leadership and operations across the Department of Public Utilities. Richmond's water treatment plant is safe, resilient, and better prepared to serve residents and regional customers through day-to-day operations, extreme weather, and emergencies.
Mayor Danny Avula said, "One year ago, we faced a challenge that tested our community. Today, I can confidently say that Richmond is stronger than ever. We've invested in people, processes, and technology to ensure safe, reliable water for every resident and our regional customers. Last year was incredibly difficult, but it is firmly in the rearview mirror."
A Year of Action and Improvement
Since January 2025, Mayor Avula and his team, including Chief Administrative Officer Odie Donald and Scott Morris, Director, Department of Public Utilities (DPU), have implemented sweeping changes to ensure reliability and resilience, beginning with rebuilding leadership and operational capacity.
Department of Public Utilities (DPU) Director Scott Morris, a professional engineer hired by Mayor Avula in January 2025, emphasized the department's shift in approach: "We've taken every lesson from last year and turned it into action. Our systems are upgraded, our leadership is stronger, and our focus is now on prevention, not just reacting to a crisis. Our commitment is delivering excellence. I'm proud of the team for the work it took to get us here, and the future of DPU."
The restructured DPU leadership team now brings over 140 years of combined experience, most of it from professional engineers. New Deputy Directors oversee Water Operations, Compliance, Engineering Services, Administration, and Customer Service, supported by senior staff at the Water Treatment Plant. Additional operators have been added to every shift to strengthen operational capacity.
Since the January 2025 water outage, DPU has advanced a series of capital and infrastructure improvements focused on strengthening the physical systems that keep the Water Treatment Plant operating safely and reliably. These investments modernize core electrical and pumping systems, add redundancy, and strengthen containment to build a more resilient plant.
Key 2025 infrastructure upgrades include:
- Upgrades to SCADA and filter uninterruptible power supply (UPS) systems to increase runtime capacity
- Replacement and repair of filter effluent valves
- Ongoing integration of backup generators
- Repair of leaks and construction of additional secondary containment
- Redesign of overflow pumping systems
- Replacement or repair of finished water pumps

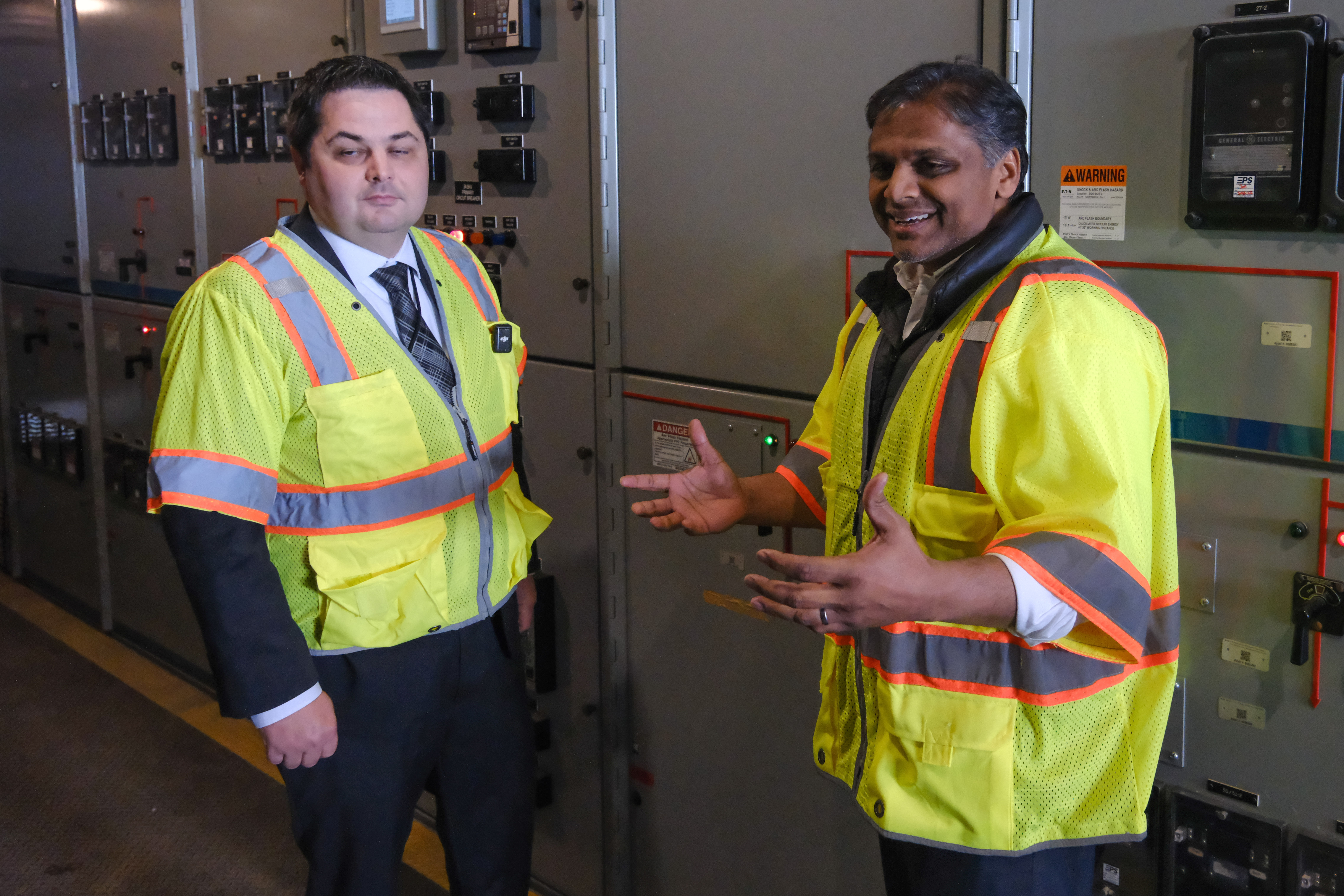

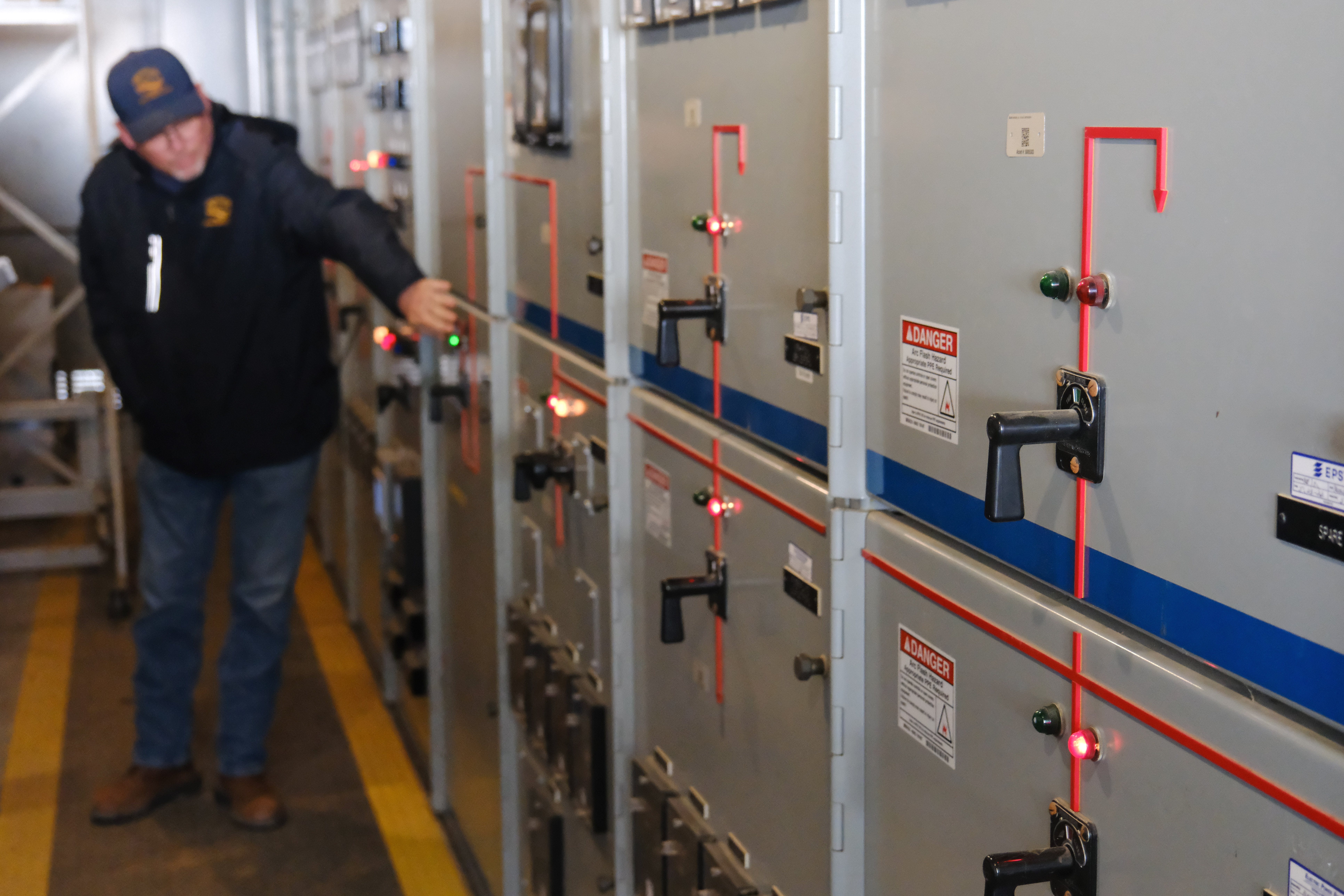

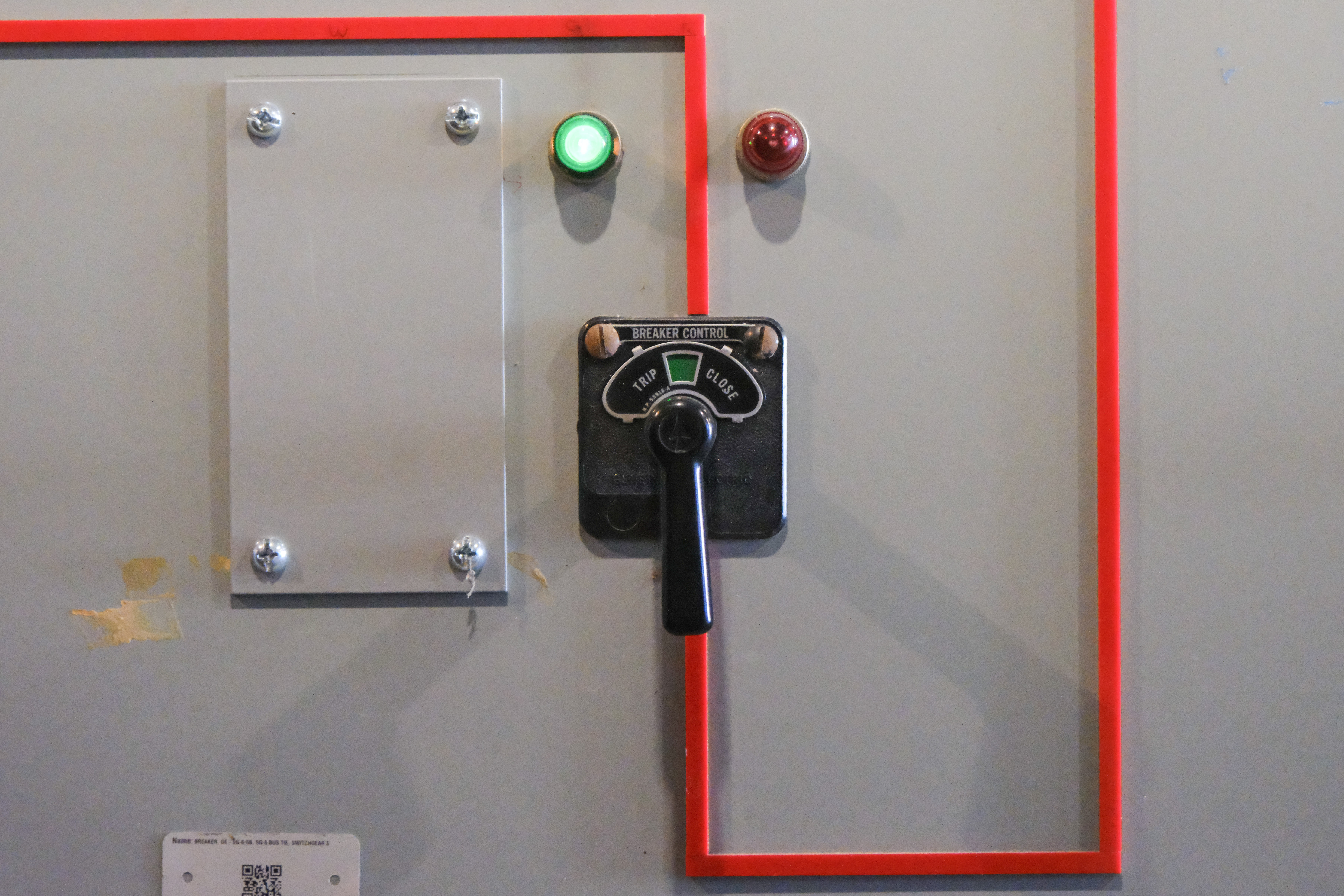

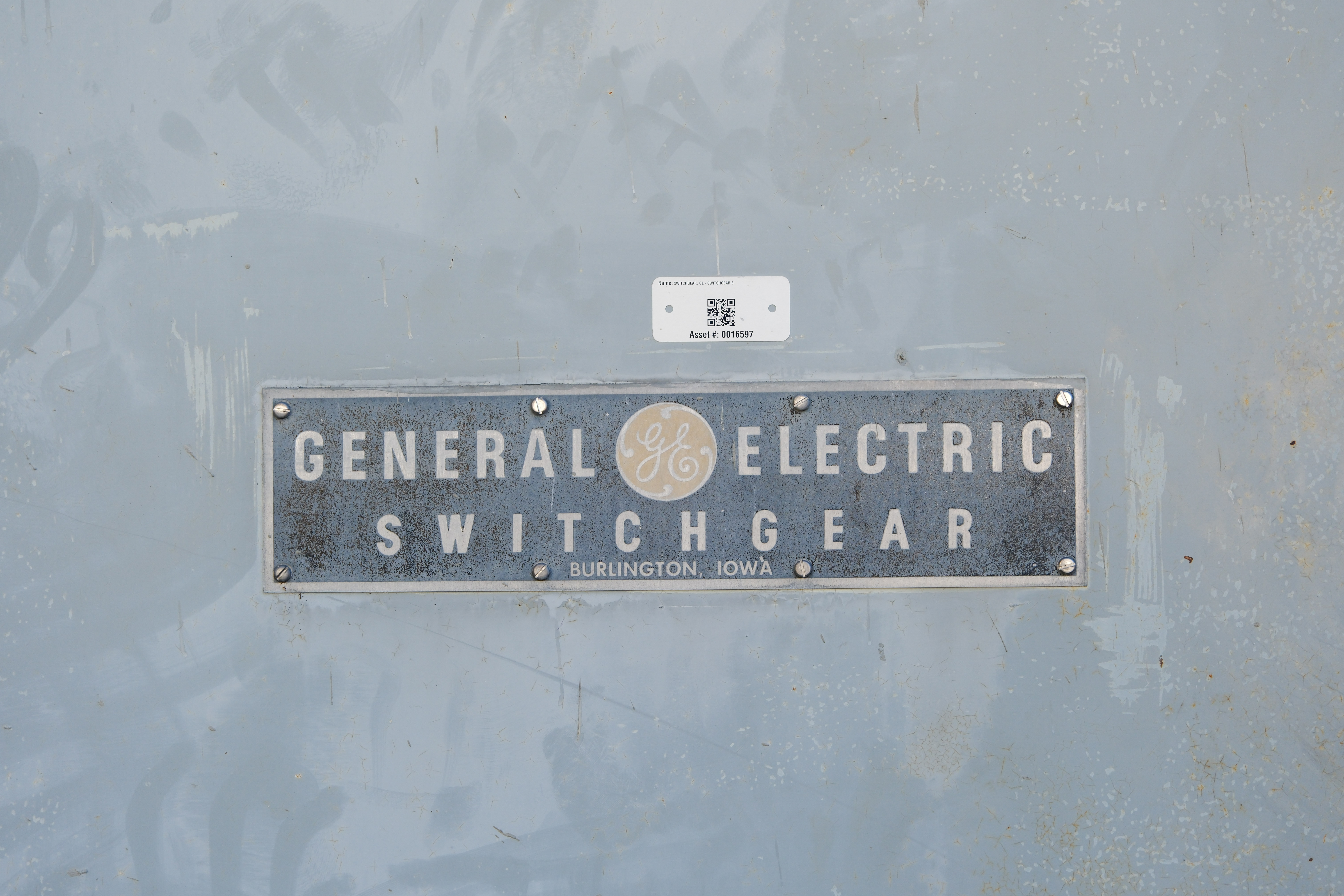

These efforts culminated in November 2025 with completion of the long-term switchgear project, delivering a critical infrastructure safeguard that did not exist during the January water outage. The newly installed and fully tested Automatic Transfer Switch (ATS) ensures uninterrupted power to the Water Treatment Plant even in the event of primary and secondary power loss. This milestone significantly strengthens system reliability and represents a major step forward in modernizing Richmond's water infrastructure.
Chief Administrative Officer Odie Donald said, "A commitment to excellence and accountability has guided each and every decision made during this past year as we continue to improve the water system. Richmonders deserve nothing less. Our best-in-class compliance rate and impactful capital improvement projects are proof of our commitment to Richmond residents and our willingness to do the hard things that improve the services we provide. That's our commitment to a Thriving Richmond."
100% of Consent Order Requirements Have Been Met
Additional key milestones achieved over the past year include:
- 93% of all internal and external recommendations (EPA, VDH, HNTB, SEH) have been completed; remaining items are tied to planned capital projects.
- All consent order requirements have been met, with the latest quarterly update submitted October 10, 2025.
- Continued compliance with the EPA required Consumer Confidence Report, which was submitted ahead of schedule and notes 100% compliance with all federal and state Safe Drinking Water Act Maximum Contaminant Levels (MCLs) for the reporting period.
Prepared for the Future
Richmond's water system is now equipped with redundant systems, strengthened emergency and communication plans, and a highly trained workforce prepared to respond quickly and effectively to any potential disruption.
Regional Coordination and Partnerships
Over the past year, the City strengthened coordination with state and regional partners to improve shared infrastructure planning, emergency preparedness, and long-term resilience.
The City worked closely with state and regional partners through regular meetings and coordinated capital planning efforts, including:
- May 30: Initial Capital Improvement Program (CIP) coordination meeting with regional partners
- June 30: Joint convening of Richmond and Henrico bodies
- August 18: Follow-up regional CIP meeting
- August 25: Regional emergency preparedness exercise
- September 30: Coordinated field testing along the 36" Hermitage Road water transmission main with Richmond, Hanover, and Henrico
"I appreciate that Mayor Avula and his team have been working assiduously on remedying this. Unfortunately, our water infrastructure is old and outdated and it will take time-and money-to fix it. I'm committed to making that happen so no one ever goes without access to clean, safe water again. As you probably remember, sadly, some of our neighboring communities were also impacted, and I am committed to working with my regional colleagues to fix this for the entire area and to ensure we all have a first class, modern water infrastructure that cannot and will not fail us," said Delegate Betsy Carr, Virginia House of Delegates.
With operational improvements, compliance goals, and leadership changes in place, Richmond is better prepared than ever to protect public health and deliver safe, reliable water to the communities it serves. This year of progress reflects the City's commitment to getting the fundamentals right and building a Thriving Richmond for today and the future. One year later, Richmond's water system is stronger, safer, and ready.
